This is the second installment in our blog series on the Scheduler.
In Part 1, we walked through the initial setup of the Scheduler. Now, in Part 2, we’ll explore how to effectively interact with the Scheduler to enhance usability and user experience.
The Thinkwise Scheduler supports a variety of interaction methods, such as creating activities by clicking on empty time slots, editing them through double-click actions, and assigning external resources via drag-and-drop. In this blog, we’ll demonstrate each interaction technique and show you how to integrate them into the Scheduler we configured in the previous part.
Interaction Methods
Click to create a new Activity
This feature allows users to click a time cell to initiate a task for quick data entry directly in the scheduler.

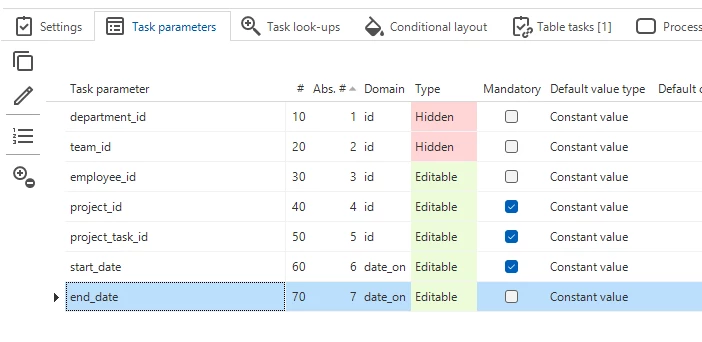

Start by creating a new task ‘project_planning_scheduler_add_activity’. Add task parameters for all fields that are needed to create a new activity:

Assign this task as a table task to the scheduler view. To make this tasks actually add a new task to the ‘project_task’ I have written a control procedure that will insert the data into this table.
Go back to the scheduler screen. In the form, go to the field ‘Add activity task’ and select the task we just created. Note that only table tasks assigned to our scheduler view will appear in this list. Set the ‘Start date time parameter’ field to ‘start_date’. This will automatically fill the start date task parameter with the date of the timecell the user selected. The ‘resource_id’ will automatically be filled as well.

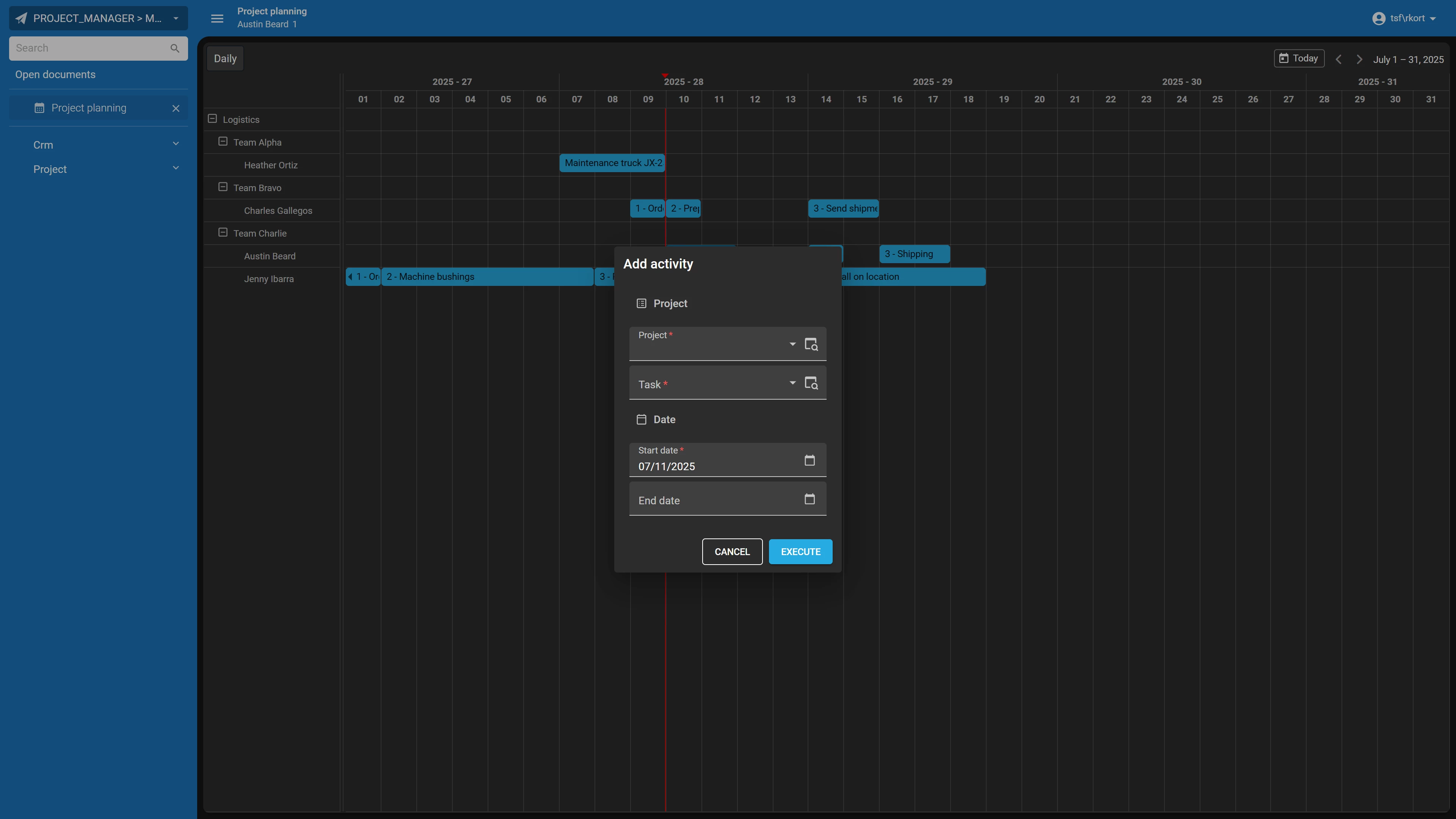

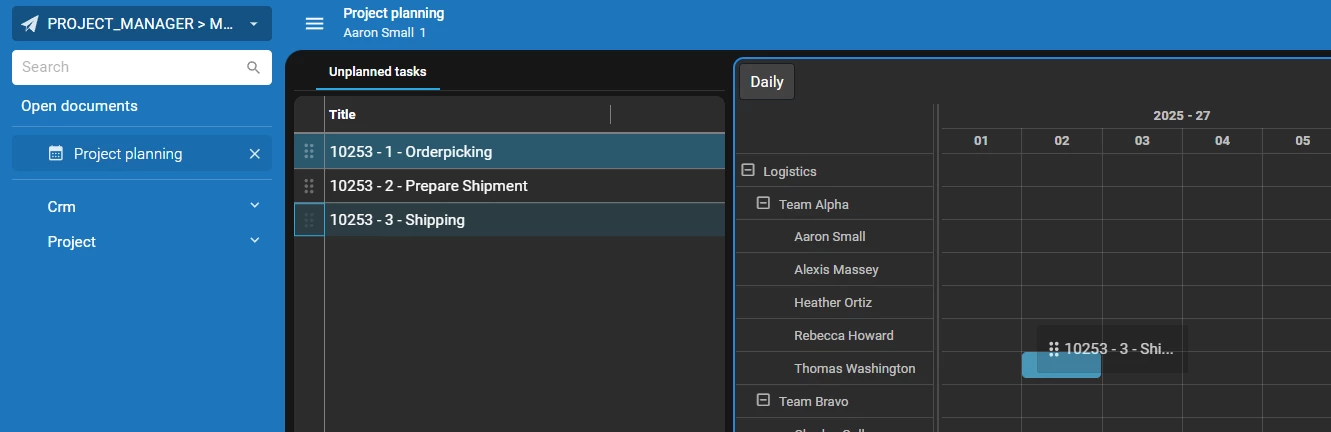

Now, clicking an empty time cell will trigger the add activity task:

Drag, Drop or Resize an Activity
To drag, drop or resize an activity the schedulers will use the subject’s update handler. Because schedulers are based on views the update handler needs to update the underlying tables.
For our example I have written a handler that will update the ‘project_task’ table with the new ‘start_date’, ‘end_date’ and ‘assigned_to_employee_id’ values.

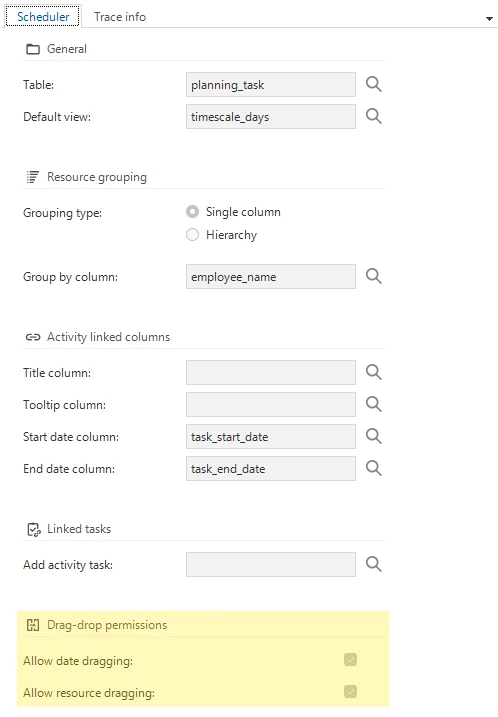

Once the update handler is set up, check the ‘Drag-drop permissions’ form group of your scheduler. ‘Allow date dragging’ will allow the user to change the start and end time of an activity. ‘Allow resource dragging’ will allow the user to change the resource to which the activity is assigned. By default both options will be active.
For example: if a user is only allowed to change the start and end time of an activity but not to which resource it is assigned, set ‘allow date dragging’ to 1, and set ‘allow resource dragging’ to 0.

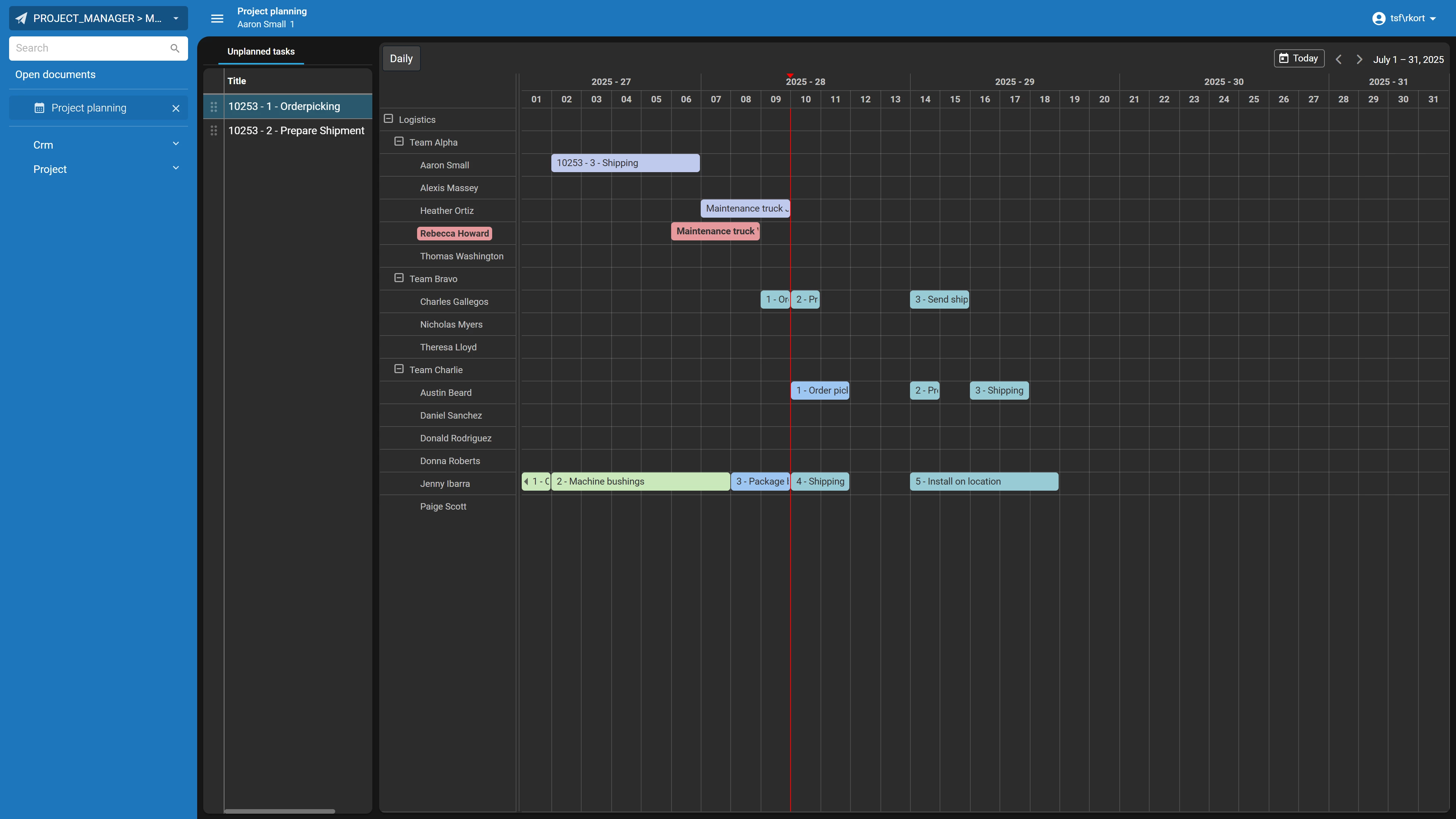

After refreshing the model we are able to drag-drop and resize activities.
Double Click on an Activity
Double-clicking an activity can trigger tasks to show more info or edit an activity.

To enable double click on an activity you need to set up a double click task on the scheduler’s subject.
For our example we will add a double click that opens detail information about the activity.
Create a new task: ‘project_planning_open_activity_details’. This is the task that will be started when we double click on an activity. Add ‘project_id’ and ‘project_task_id’ as task parameters. These will allow us the open the correct task detail screen using a process flow.

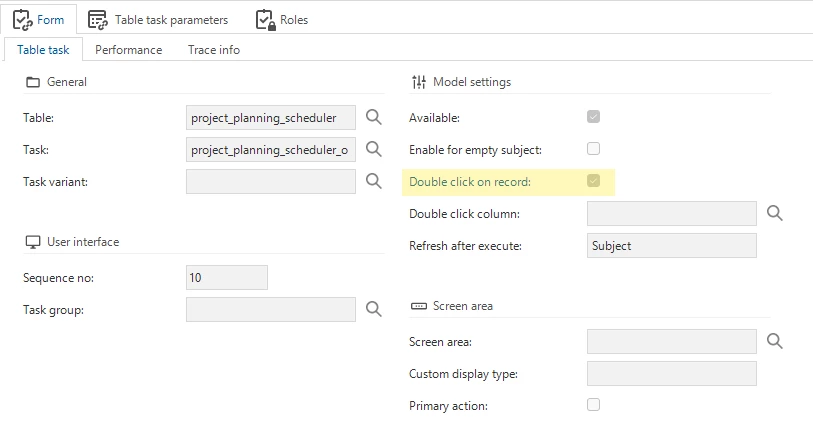

Assign the task as a table task to our scheduler view. In the table task form check ‘Double click on record’.

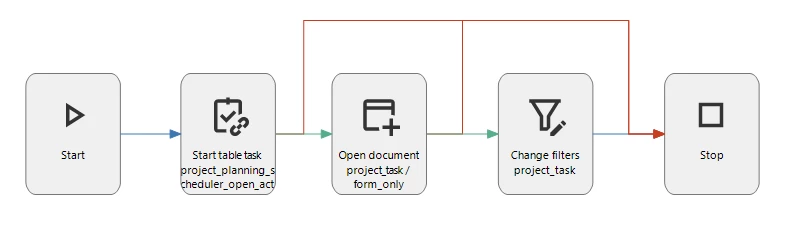

This is enough to start a task when a user double clicks an activity. To open a detailed view of the activity, we also need the following process flow:

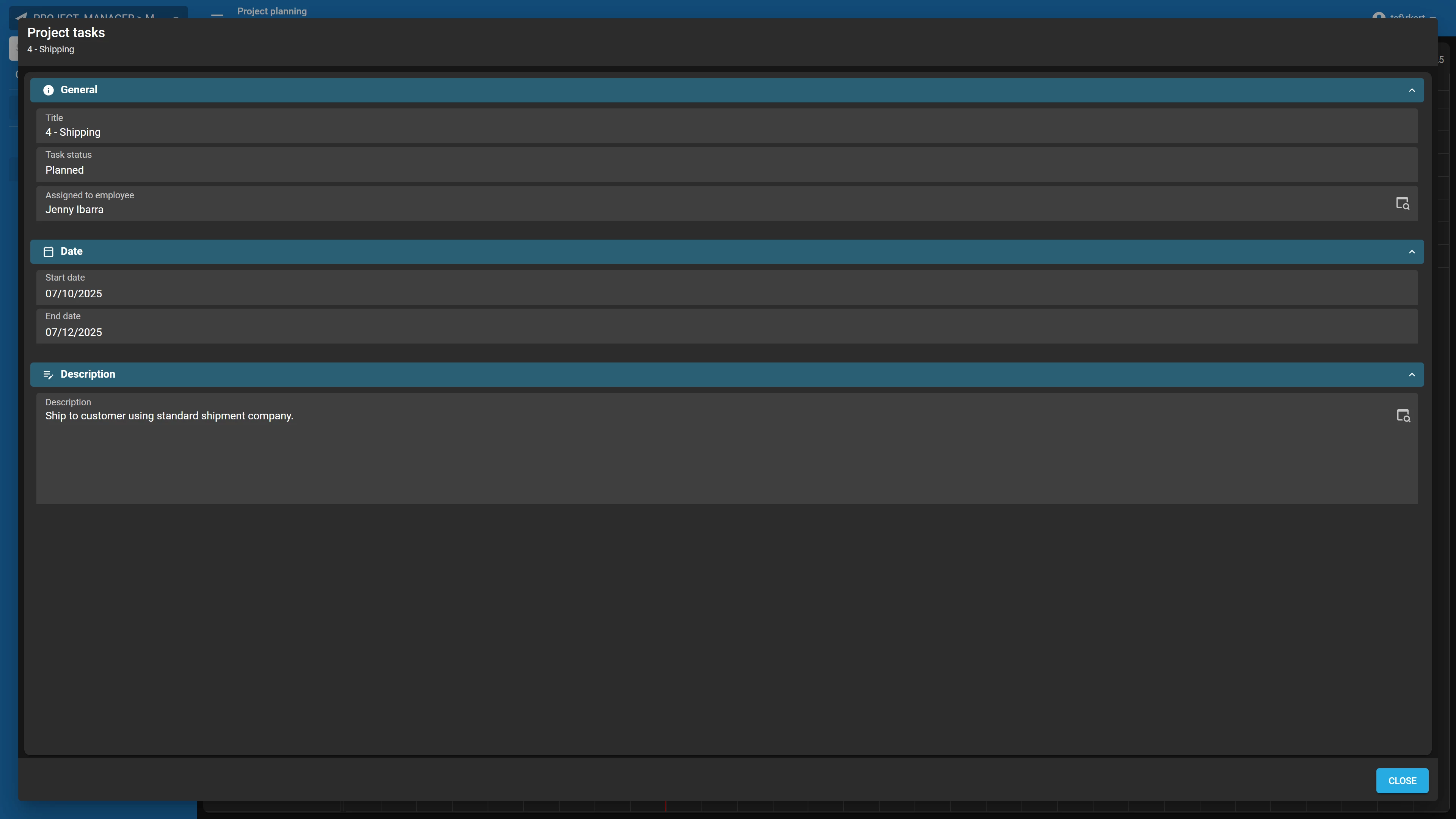

After refreshing the model, we can double click any activity and its details will now be opened in a modal popup:

Drag & Drop External Item as new Activities on a Scheduler
External Drag & drop allows you to drag an item from a separate list onto a scheduler to add it as an activity.
For our example we have a scheduler that shows all tasks that have been assigned to an employee. But to make it easy to assign new tasks to an employee we want to have a list of unassigned tasks on our screen, that we can drag and drop onto an employee and date.

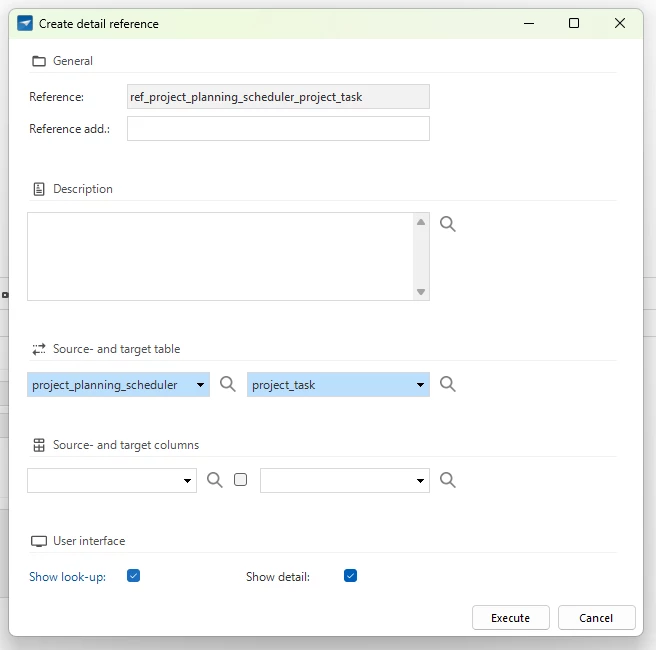

Let’s start by displaying the ‘project_task’ on our scheduler screen. To do this we create an empty reference between our scheduler view and the ‘project_task’ table:

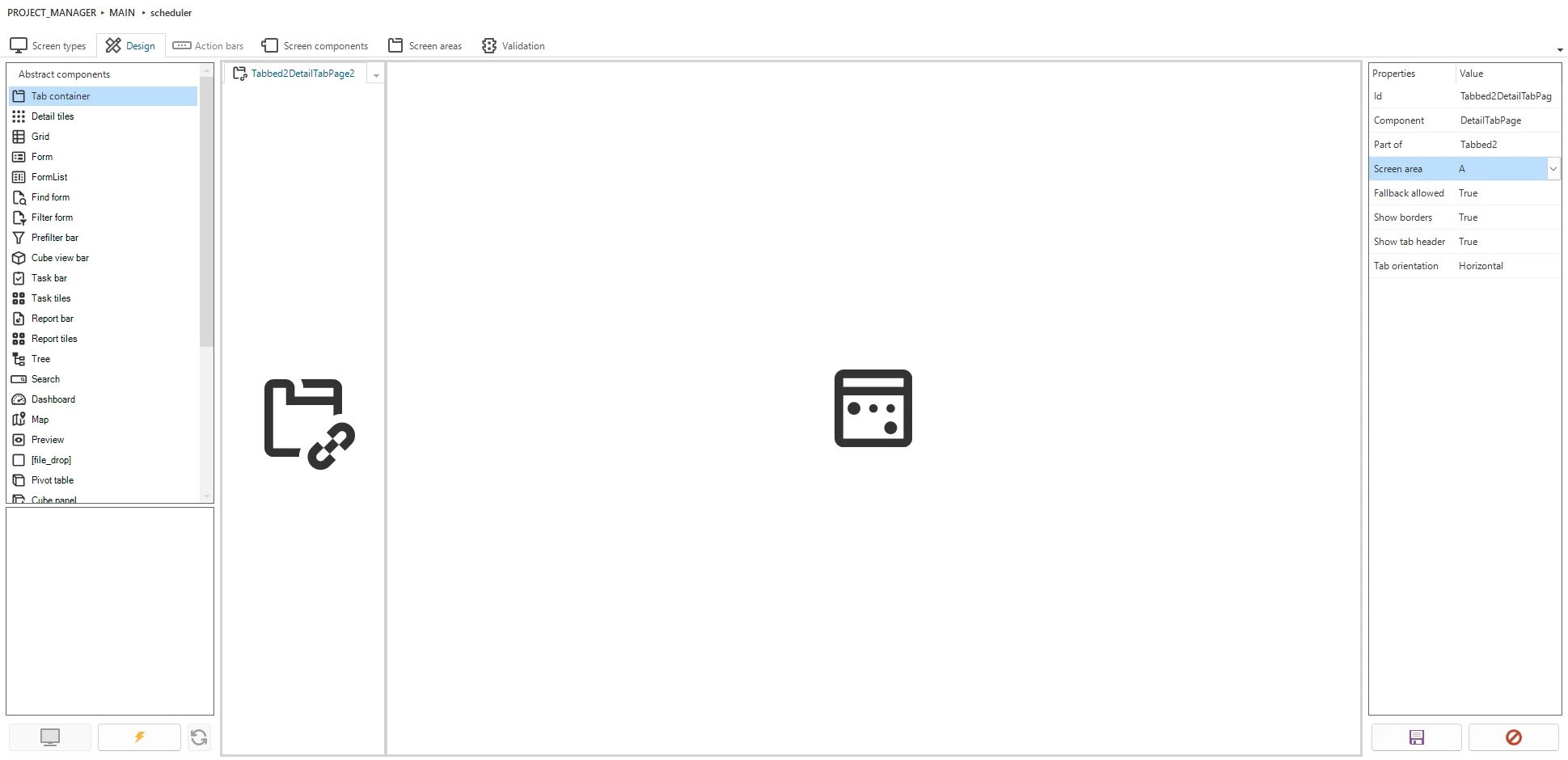

We need to change the screen type we created earlier to also display a detail tab. Our screen type now looks like this:

To make the ‘project_task’ detail look clear, I have made a variant of it that uses a screen type with only a grid. In the variant’s grid I have set all columns on hidden, except for the project task title column. I also applied a prefilter to this variant to only show tasks that have not yet been assigned to an employee.

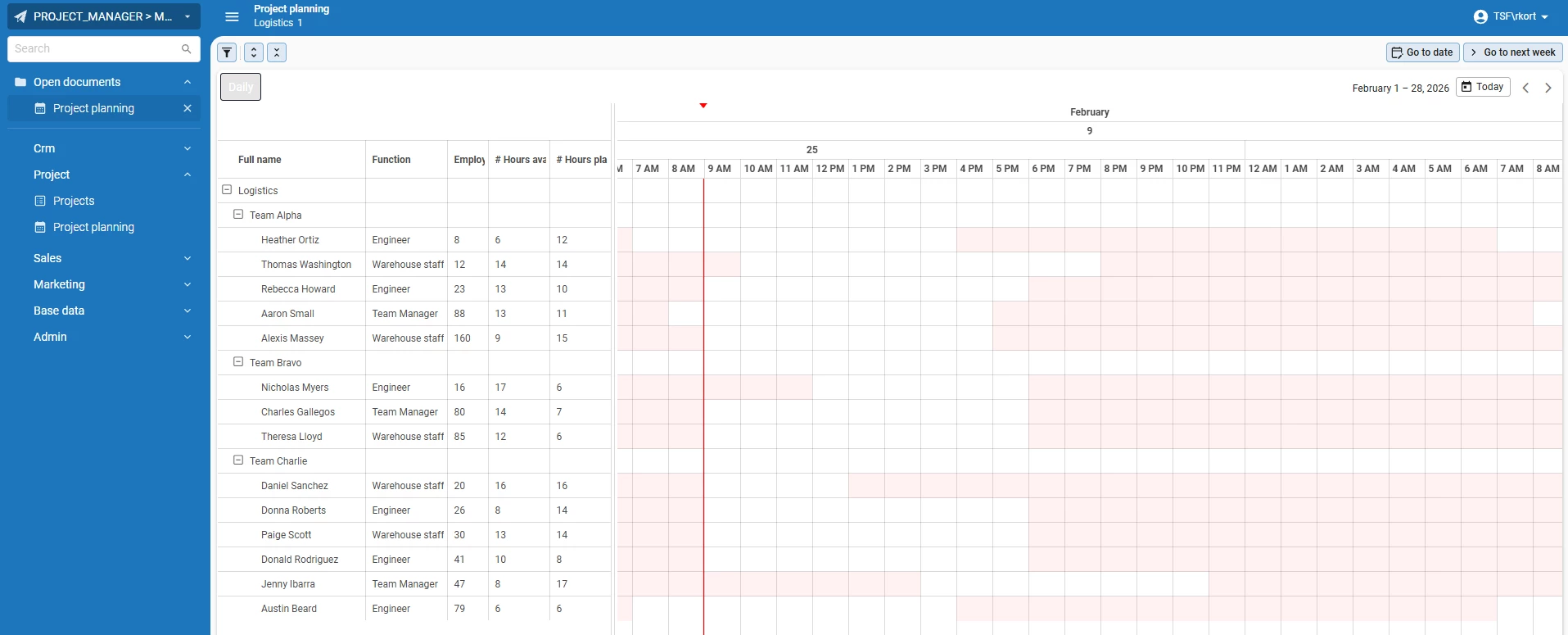

After refreshing our scheduler screen, we will have a detail grid on the left, and our scheduler on the right:

Enabling Drag-drop

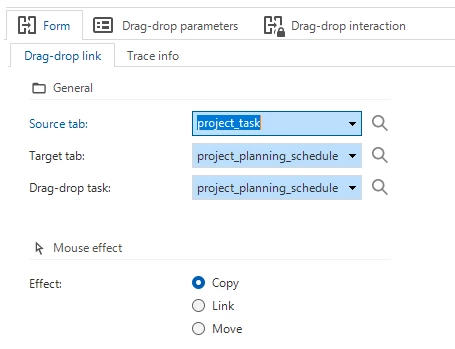

Open the subject screen, select the ‘project_task’ table, and navigate to links -> Drag-drop. Click on add in the form to create a new drag-drop link. The source will automatically be filled, select ‘project_planning_scheduler’ as the target. For the drag-drop task we reuse the add activity task we created earlier.

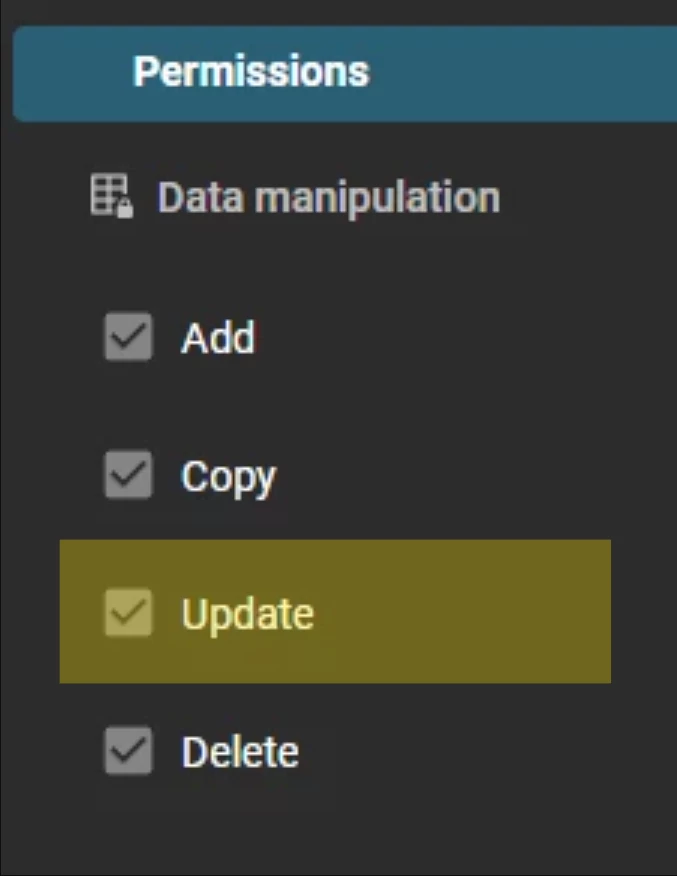

Then assign the ‘project_id’ and ‘project_task_id’ as Drop-drop parameters. Make sure that the drag-drop interaction is activated on both the source and the target subject.

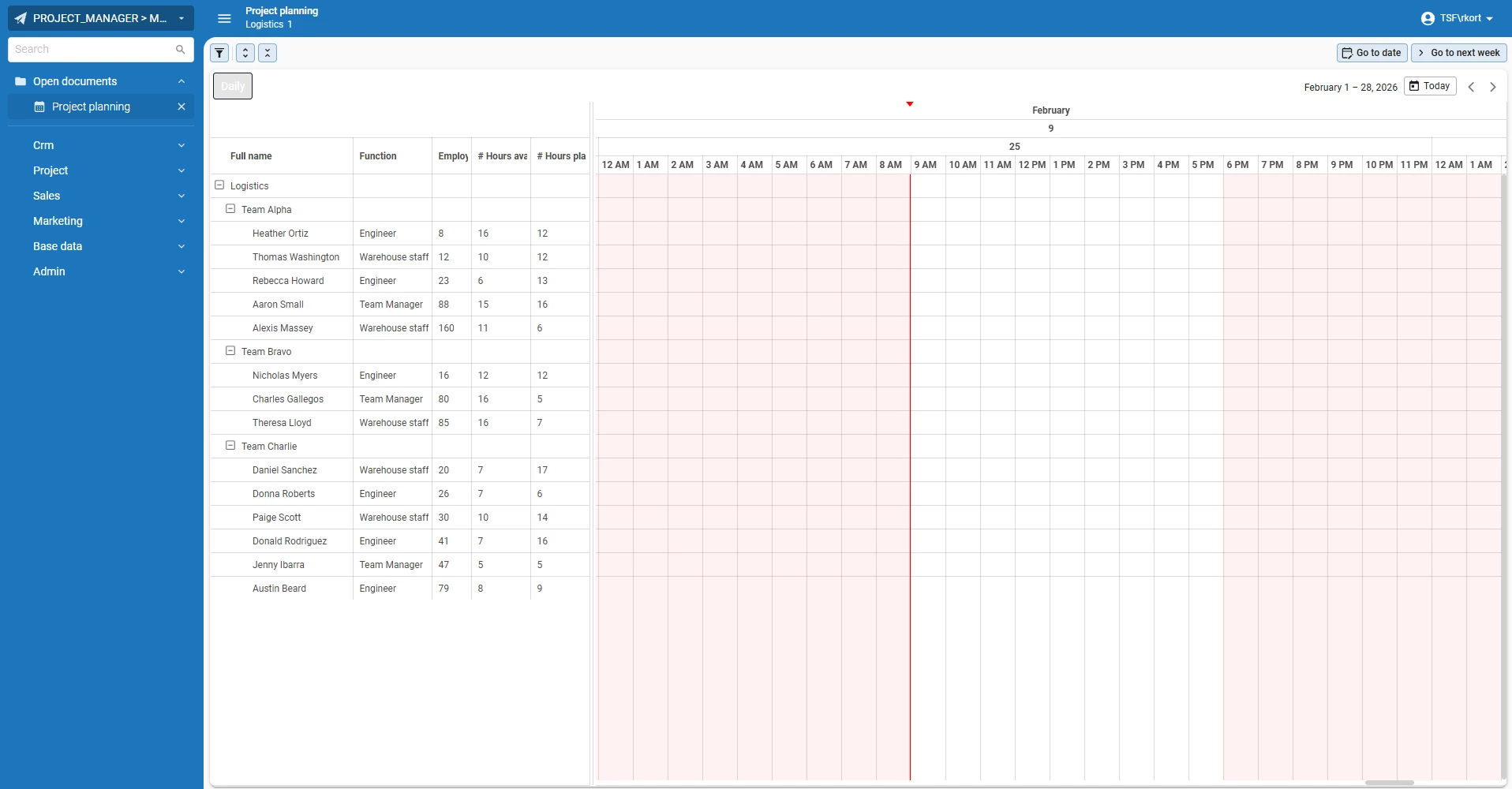

Because we already setup the add activity task earlier, we are be able to drag and drop tasks from the list onto our scheduler:

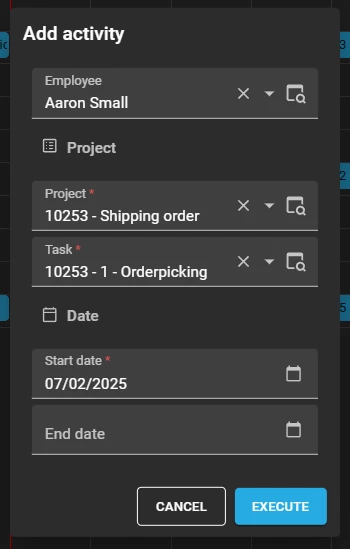

In the task popup, the parameters have been automatically filled:

Conditional Formatting
The scheduler allows you to style activities, resources and time cells. This can be useful when you want to highlight activities or resources that might need the users attention.
Activities
To control the color of an activity I have added the column ‘project_task_status’ to the scheduler view. After setting up this column we add a conditional layout for every possible status of the project task. To apply a conditional layout to an activity make sure that the applied to column in the form is set to the activity title of your scheduler.

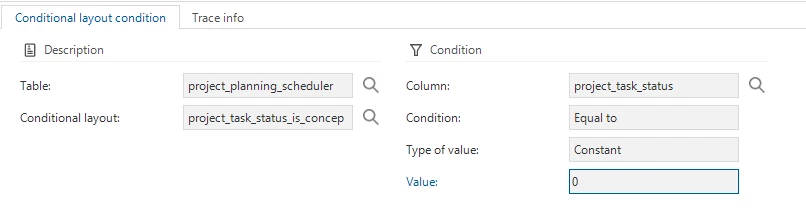

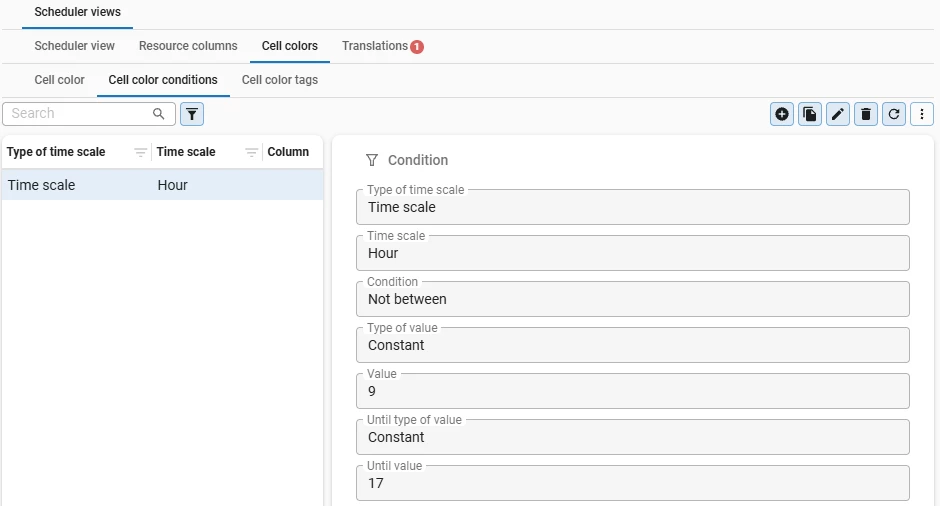

For our scheduler we want to filter on the different statuses of the task, to do this i am using the ‘project_task_status ’ column as the filter condition.

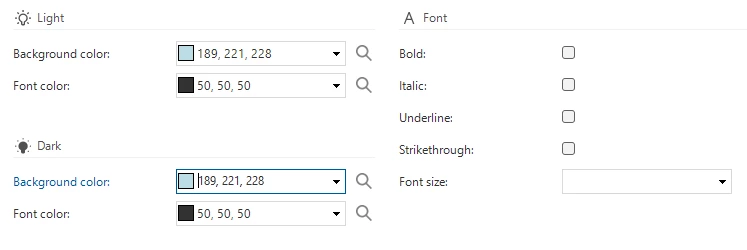

In the 2025.2 release we have introduced new styling options. You now have the ability to control the font size and can add an underline or a strikethrough to text.

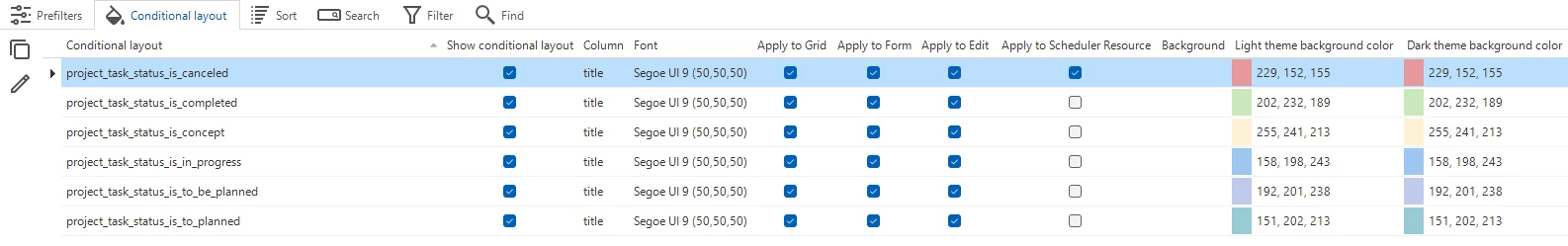

In this example I have the given the various status options a different background color. This should result in the task activities having a background color based on their task status.

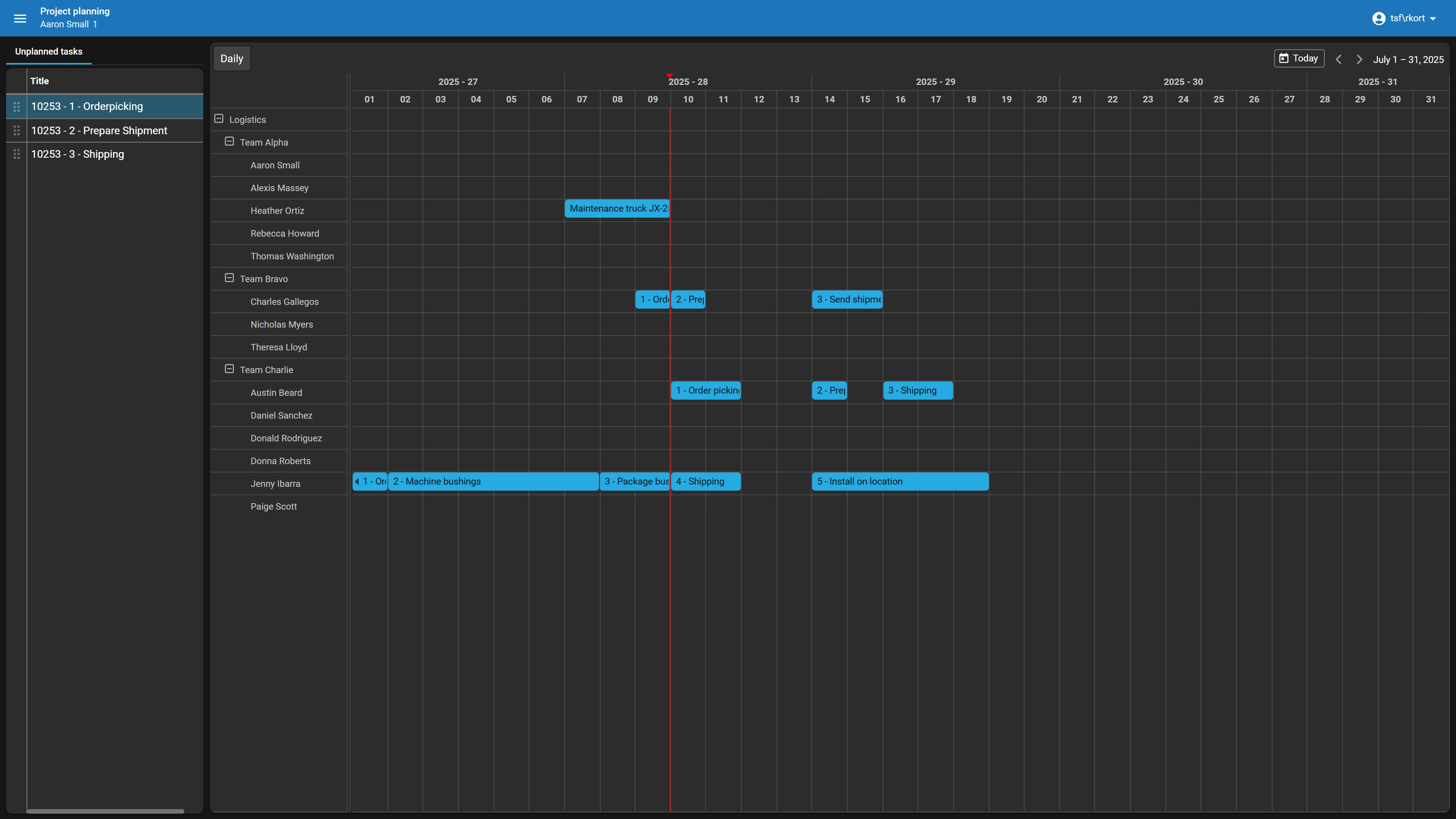

After refreshing the model, we get the following result:

Resources
Sometimes it can be powerful to color a resource. For example when there is something wrong and you want to immediately draw attention, you can color the background of the resource to be red. Resources are also styled using conditional layouts.

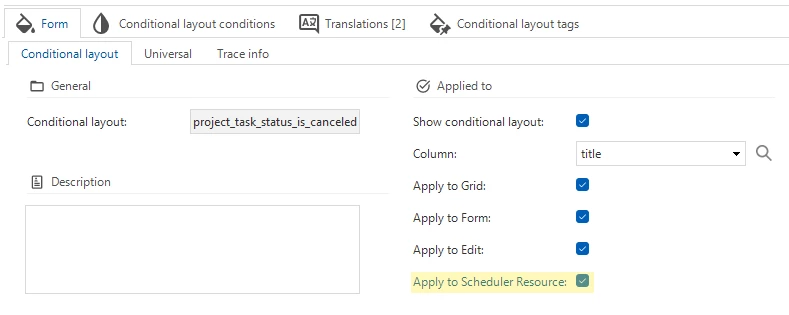

In the form of a conditional layout we have the option to also apply the conditional layout to the resource. In this example we set this to yes for the status canceled, so we will color the background of the resource red if there is any activity with the status canceled for this resource.

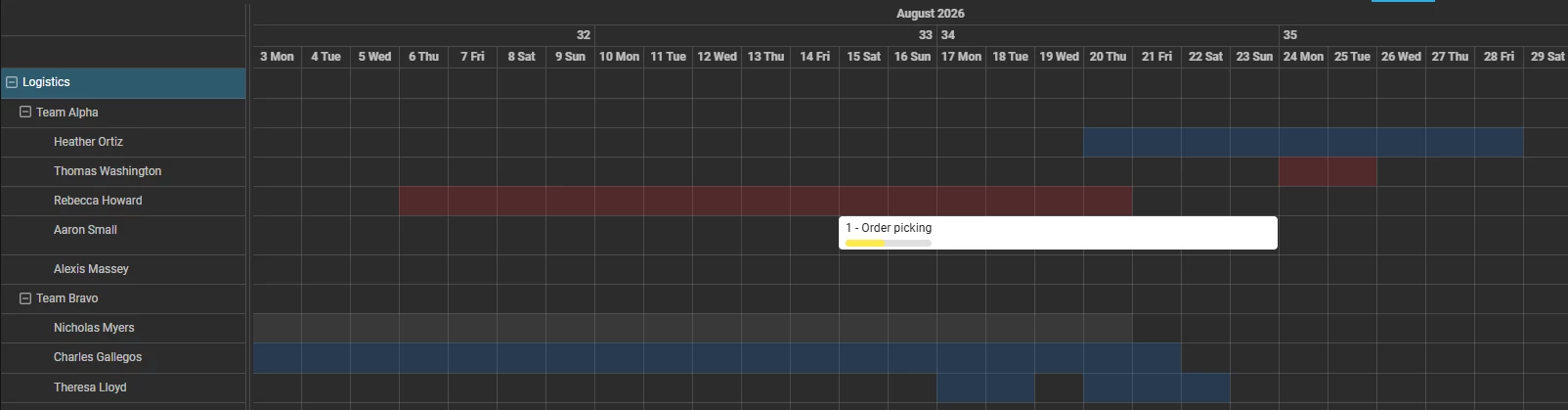

After refreshing the model, the resource now has a red background:

If you only want to apply conditional formatting to the resource but not to an activity select in the applied to column in the conditional layout any column except for the activity title column.
